List of steps
(Total number of steps: 71)
Meet IPA

Obtain certified copies of foreign documents  (2)

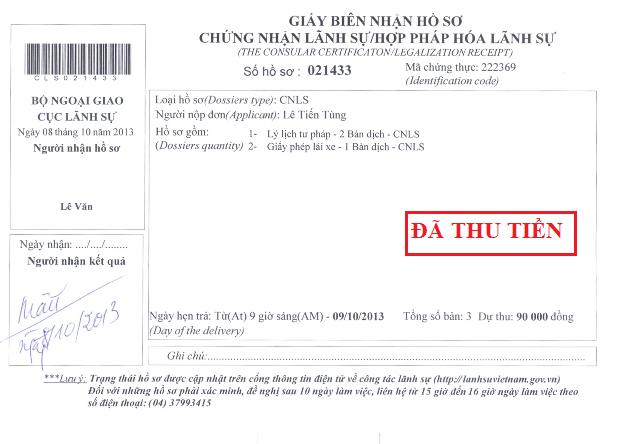

Obtain consular legalized copies of documents  (3)
Obtain certified translation of documents  (2)
Obtain approval of investment intent  (2)
Obtain authenticated copies for land and infrastructure lease  (2)
Lease infrastructure inside industrial zone  (1)
Obtain authenticated copies for investment certificate application  (2)

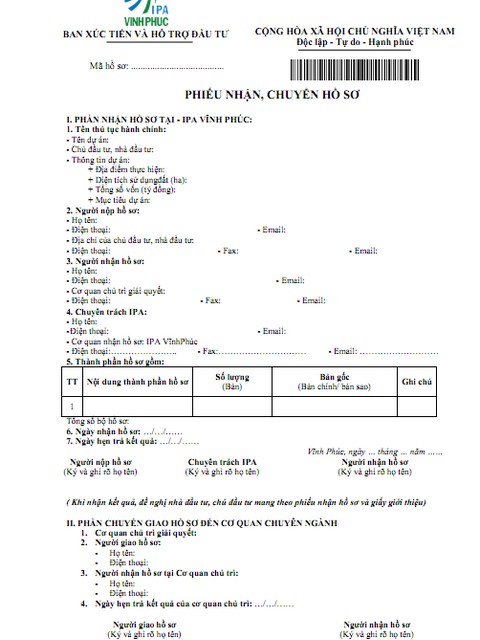

Declare investment project information online
Obtain investment registration certificate  (2)
Obtain authenticated copies of IRC  (2)
Obtain Enterprise Registration Certificate (ERC)  (3)
Obtain seal and seal registration certificate  (2)
Obtain certificate of tax registration  (2)
Open bank account  (1)
Publish in newspaper  (1)

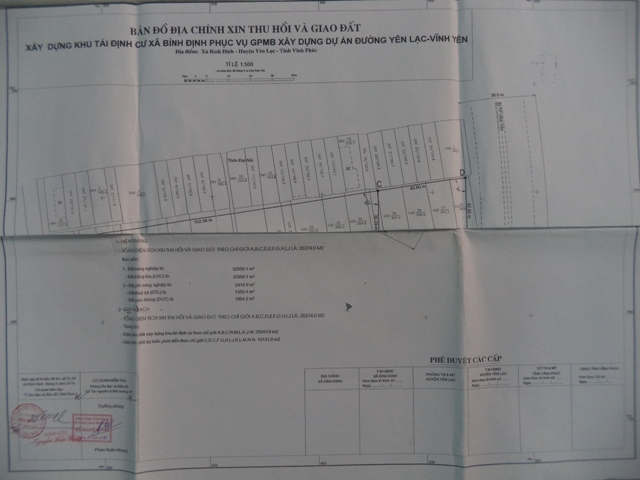

Obtain cadastral map of investment site  (3)
Obtain fully-signed cadastral map  (4)

Pay costs for land clearance  (2)
Obtain authenticated copies of cadastral map and certified payment order  (2)
Obtain decision on land recovery and lease  (2)
Attend on-site title plan verification  (1)
Obtain authenticated copies for land lease contract application  (2)
Sign land lease contract  (2)
Obtain authenticated copies of land lease contract  (2)

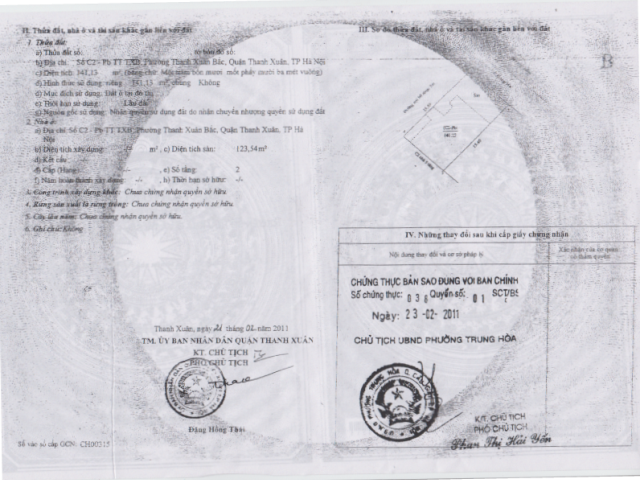

Obtain land use right certificate  (4)
Obtain approval of environmental impact assessment (EIA) report  (6)
Obtain authenticated copies of land use right certificate, EIA  (2)
Obtain construction design profile  (2)
Obtain appraisal on construction design profile  (2)
Obtain fire prevention and fighting (FPF) profile  (2)
Obtain certificate of fire prevention and fighting approval  (2)
Obtain construction permit  (2)
Make seal and notify seal specimen  (2)
70
Make seal

Preview & Print

Properties

Summary of the procedure

Where to go? (22)

You will have to go to the following agencies. The number indicates how many interactions are required with each entity.
Vinh Phuc Investment Promotion and Support Agency (x 22)
Vinh Phuc Investment Promotion and Support Agency
Diplomatic missions, consular offices of foreign country (x 2)
1 2
Diplomatic missions, consular offices of foreign country
Consular Department - Ministry of Foreign Affairs (x 2)
3 5
Consular Department - Ministry of Foreign Affairs
Finance Administrative Department - Ministry of Foreign Affairs
4
Finance Administrative Department - Ministry of Foreign Affairs
Any District People's Committee
*
Any District People's Committee
Translation Company or Individual Translator (x 2)
6 7
Translation Company or Individual Translator
Any Commune/ District People's Committee (x 13)
Any Commune/ District People's Committee
Compentent authority assigned by Vinh Phuc People's Committee (x 2)
12 35
Compentent authority assigned by Vinh Phuc People's Committee
Any District People's Committees (x 3)
13 33 34
Any District People's Committees
Vinh Phuc Department of Public Security (x 2)
* 23
Vinh Phuc Department of Public Security
Any seal engraving agency (x 2)
22 70
Any seal engraving agency
Vinh Phuc Department of Taxation - Second Office (x 2)
24 25
Vinh Phuc Department of Taxation - Second Office
Any commercial bank (x 2)
26 36
Any commercial bank
Any local/national newspaper
27
Any local/national newspaper
Any entity allowed to make cadastral map (x 2)
28 30
Any entity allowed to make cadastral map
Any communes People's Committees (x 2)
29 32
Any communes People's Committees
Any Commune People's Committee
31
Any Commune People's Committee
Department of Natural Resourses and Environment
45
Department of Natural Resourses and Environment
Any treasury transaction office
49
Any treasury transaction office
Any consulting entities allowed to make EIA (x 2)
52 53
Any consulting entities allowed to make EIA
Vinh Phuc Sub-Department of Environment Protection
55
Vinh Phuc Sub-Department of Environment Protection
Any construction consulting entity (x 5)
60 * 61 62 63
Any construction consulting entity
Any fire prevention and fighting design consultant (x 2)
64 65
Any fire prevention and fighting design consultant

What you will get (8)

The objective of the procedure is to obtain those documents.
Investment certificate*****
16
Investment certificate*****
Seal
23
Seal
Seal registration certificate
23
Seal registration certificate
Certificate of tax registration
25
Certificate of tax registration
Signed land lease contract
45
Signed land lease contract
Land use right certificate*
51
Land use right certificate*
Decision on EIA approval
57
Decision on EIA approval
Certificate on fire prevention and fighting
67
Certificate on fire prevention and fighting

Required documents

The documents with green band will be provided to you during the procedure.

Information or documents relating to the project
*
Information or documents relating to the project
Information or documents relating to investor(s)
*
Information or documents relating to investor(s)
Certificate of Incorporation (x 2)
1 12
Certificate of  Incorporation
2 latest years audited financial report
1
2 latest years audited financial report

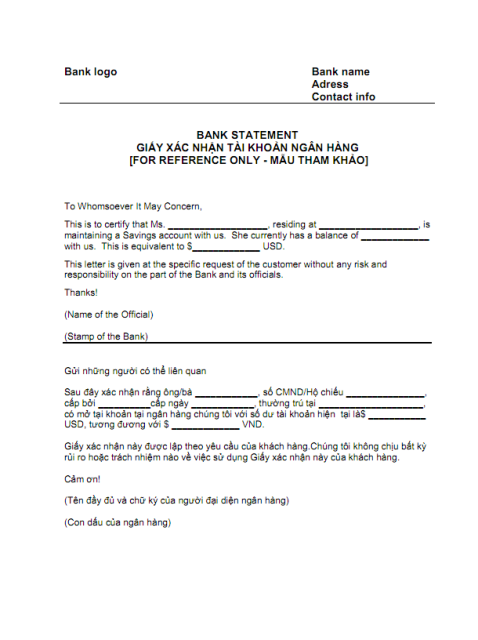

Bank statement (x 2)
1 15
Bank statement
Application for consular legalization
3
Application for consular legalization
Passport or Vietnamese ID card of the applicant (x 9)
Passport or Vietnamese ID card of the applicant
Passport or Vietnamese ID card of the applicant (x 4)
3 5 19 23
Passport or Vietnamese ID card of the applicant
Certified copy of certificate of incorporation
3
Certified copy of certificate of incorporation
Vietnamese or English version of Certificate of Incorporation
3
Vietnamese or English version of Certificate of Incorporation
Simple copy of Certificate of Incorporation
3
Simple copy of Certificate of Incorporation
Certified copy of 2 latest years audited financial report
3
Certified copy of 2 latest years audited financial report
Vietnamese or English version of latest audited financial statement
3
Vietnamese or English version of latest audited  financial statement
Simple copy of latest audited financial statement
3
Simple copy of latest audited financial statement
Certified copy of bank statement
3
Certified copy of bank statement
Vietnamese or English version of bank statement
3
Vietnamese or English version of bank statement
Simple copy of bank statement
3
Simple copy of bank statement
Certified copy of bank statement
3
Certified copy of bank statement
Vietnamese or English version of bank statement
3
Vietnamese or English version of bank statement
Simple copy of bank statement
3
Simple copy of bank statement
Consular legalization receipt
4
Consular legalization receipt
Payment receipt (consular)
5
Payment receipt (consular)
Consular legalization receipt (Paid)
5
Consular legalization receipt (Paid)
Legalized copy of certificate of incorporation (x 2)
6 8
Legalized copy of certificate of incorporation
Consular legalized copy of 2 latest years audited financial report (x 2)
6 8
Consular legalized copy of 2 latest years audited financial report
Payment receipt
7
Payment receipt
Application for implementing investment project
8
Application for implementing investment project
Preliminarily explanation on investment project
8
Preliminarily  explanation on investment project
Certified translation of certificate of incorporation
8
Certified translation of certificate of incorporation
Certified translation of 2 latest years audited financial report
8
Certified translation of 2 latest years audited financial report
Statement on the investor's experience
8
Statement on the investor's experience
Document receipt and transfer slip (for investment intent)
9
Document receipt and transfer slip (for investment intent)
Approval of investment intent
10
Approval of investment intent

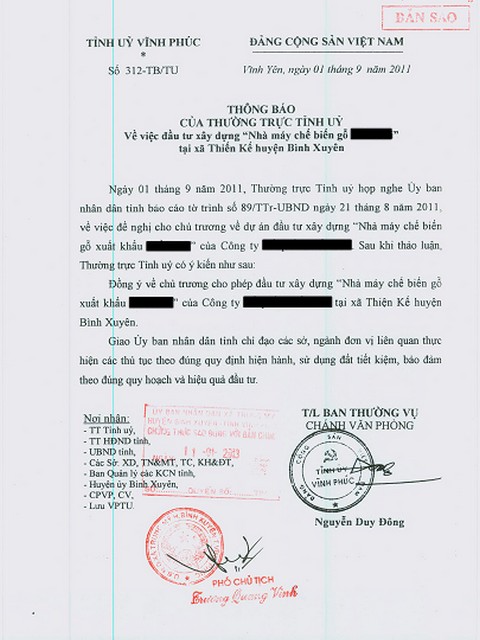

Notice of Standing Party Committee
10
Notice of Standing Party Committee
Passport or Vietnamese ID card of investor's authorized representative
10
Passport or Vietnamese ID card of investor's authorized representative
Passport or Vietnamese ID card of individual investor(s)
10
Passport or Vietnamese ID card of individual investor(s)
Receipt of application file
11
Receipt of application file
Authenticated copy of approval for investment project intent (x 4)
Authenticated copy of approval for investment project intent
Proof of quality of the legal representative(s) of corporate investor
12
Proof of quality of the legal representative(s) of corporate investor
Authenticated copy of passport or Vietnamese ID card of investor's representative (x 2)
12 15
Authenticated copy of passport or Vietnamese ID card of investor's representative
Authenticated copy of passport or Vietnamese ID card of individual investor (x 2)
12 15
Authenticated copy of passport or Vietnamese ID card of individual investor
Passport or Vietnamese ID card of legal representative of company to be set up
13
Passport or Vietnamese ID card of legal representative of company to be set up
MoU on infrastructure leasing_VI
13
MoU on infrastructure leasing_VI
Receipt of application file
14
Receipt of application file
Request/ Registration for issuance of investment certificate (Appx.I-3)
15
Request/ Registration for issuance of investment certificate (Appx.I-3)
Report on financial capability
15
 Report on financial capability
Statement/ Presentation on investment project (x 4)
Statement/ Presentation on investment project
Draft company charter (x 2)
15 19
Draft company charter
Authenticated copy of passport or Vietnamese ID card of company's legal representative
15
Authenticated copy of passport or Vietnamese ID card of company's legal representative
List of company members (x 2)
15 19
List of company members
Certified translation of bank statement
15
Certified translation of bank statement
Legalized copy of certificate of incorporation (x 2)
15 19
Legalized copy of certificate of incorporation
Certified translation of certificate of incorporation (x 2)
15 19
Certified translation of certificate of incorporation

Power of attorney (to investor's representative) (x 2)
15 19
Power of attorney (to investor's representative)
Document receipt and transfer slip (of IPA - Inside IZ)
16
Document receipt and transfer slip (of IPA - Inside IZ)
Investment certificate***
17
Investment certificate***
Receipt of application file
18
Receipt of application file
Request for enterprise registration
19
Authenticated copy of passport or Vietnamese ID card of company's legal representative (x 2)
19 26
Authenticated copy of passport or Vietnamese ID card of company's legal representative
Authenticated copy of IRC
19
Authenticated copy of IRC
Authenticated copy of passport or Vietnamese ID card of individual investor(s)
19
Authenticated copy of passport or Vietnamese ID card of individual investor(s)
Authenticated copy of passport or Vietnamese ID card of investor's representative
19
Authenticated copy of passport or Vietnamese ID card of investor's representative
Application receipt and transfer slip (for IC - outside IZ)
20
Application receipt and transfer slip (for IC - outside IZ)
Request for enterprise registration content announcement
21
Investment certificate***** (x 4)
* 22 24 27
Investment certificate*****
Authenticated copy of investment certificate*** (x 11)
Authenticated copy of investment certificate***
Power of attorney to applicant
22
Power of attorney to applicant
Appointment slip (seal)
23
Appointment slip (seal)
Application for Tax registration
24
Application for Tax registration
Appointment slip (of tax registration)
25
Appointment slip (of tax registration)
Application for opening account - Customer information registration
26
Application for opening account  - Customer information registration
Decision on appointment of chief accountant
26
Decision on appointment of chief accountant
Document(s) relating capital contribution
26
Document(s) relating capital contribution

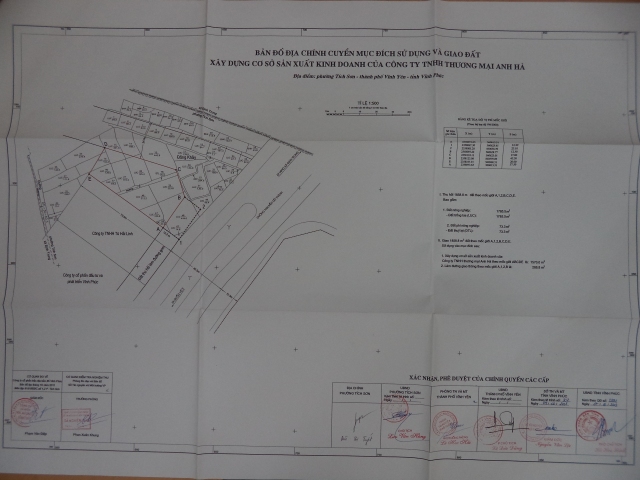

Cadastral map
31
Cadastral map
Cadastral map certified by Commune People's Committtee
33
Cadastral map certified by Commune People's Committtee
Payment order (x 2)
36 37
Payment order
Cadastral map certified by District People's Committtee(*)
37
Cadastral map certified by District People's Committtee(*)
Receipt of application file
38
Receipt of application file
Application for land lease
39
Application for land lease
Authenticated copy of notice of Standing Party Committee
39
Authenticated copy of notice of Standing Party Committee
Authenticated copy of MoU on infrastructure leasing
39
Authenticated copy of MoU on infrastructure leasing
Authenticated copy of certified payment order
39
Authenticated copy of certified payment order
Authenticated copy of cadastral map certified by District People's Committee
39
Authenticated copy of cadastral map certified by District People's Committee
Document receipt and transfer slip (of IPA-land lease)
40
Document receipt and transfer slip (of IPA-land lease)
Decision on land recovery and lease
42
Decision on land recovery and lease
Meeting minutes of on-site title plan verification
42
Meeting minutes of on-site title plan verification
Cadastral map signed by Provincial People's Committee
42
Cadastral map signed by Provincial People's Committee
Receipt of application file
43
Receipt of application file
Authenticated copy of decision on land recovery and lease
44
Authenticated copy of decision on land recovery and lease
Authenticated copy of cadastral map signed by the Provincial People's Committee (x 2)
44 48
Authenticated copy of cadastral map signed by the Provincial People's Committee
Authenticated copy of meeting minutes of on-site title plan verification (x 2)
44 48
Authenticated copy of meeting minutes of on-site title plan verification
Signed land lease contract
46
Signed land lease contract
Receipt of application file
47
Receipt of application file
Application for land use right certificate (LURC)
48
Application for land use right certificate (LURC)
Report on inspection of land fund being currently managed and used
48
Report on inspection of land fund being currently managed and used
Authenticated copy of approval for investment intent (x 4)
Authenticated copy of approval for investment intent
Decision on land recovery and lease
48
Decision on land recovery and lease
Authenticated copy of signed land lease contract
48
Authenticated copy of signed land lease contract
Declaration statement of land and water surface rental charges
48
Declaration statement of land and water surface rental charges
Notice on payment of land lease
49
Notice on payment of land lease
Payment receipt (to State Budget)
50
Payment receipt (to State Budget)
Document receipt and transfer slip (for LURC)
51
Document receipt and transfer slip (for LURC)
Application for appraisal and approval of EIA
54
Application for appraisal and approval of EIA
EIA profile
54
EIA profile
A compact disc (CD) compiled with contents of EIA
54
A compact disc (CD) compiled with contents of EIA

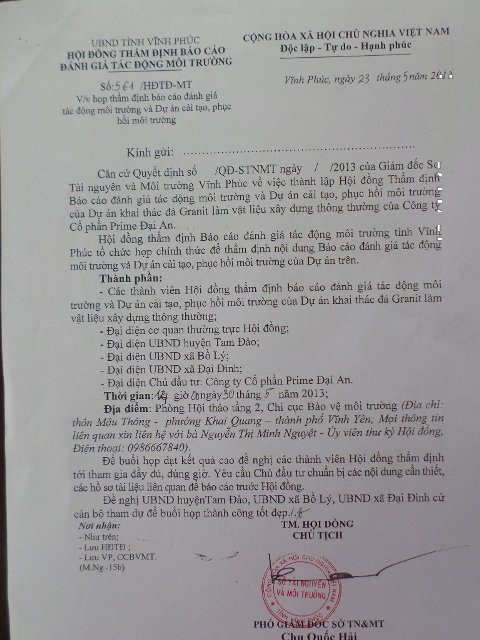

Notice of EIA appraisal meeting
55
Notice of EIA appraisal meeting
Amended environment impact assessment
56
Amended environment impact assessment
Updated compact disc compiled with contents of EIA
56
Updated compact disc compiled with contents of EIA
Statement on amendment and supplementation
56
Statement on amendment and supplementation
Document receipt and transfer slip (EIA)
57
Document receipt and transfer slip (EIA)
Land use right certificate*
58
Land use right certificate*
Decision on EIA approval
58
Decision on EIA approval
Receipt of application
59
Receipt of application
Any document/Information on design concept of construction work
60
Any document/Information on design concept of construction work
Construction design profile
62
Construction design profile
Appraised construction design profile (x 2)
64 68
Appraised construction design profile
Construction drawings embedded into CD rom
64
Construction drawings embedded into CD rom
Authenticated copy of land use right certificate
64
Authenticated copy of land use right certificate
Request for appraisal and approval for fire prevention and fighting
66
Request for appraisal and approval for fire prevention and fighting
FPF design profile
66
FPF design profile
Power of attorney (x 2)
66 71
Power of attorney
Enterprise/Business registrationcertificate
66
Enterprise/Business registrationcertificate
Certificate of fire prevention and fighting consulting
66
Certificate of fire prevention and fighting consulting
Document receipt and transfer slip (for FPF)
67
Document receipt and transfer slip (for FPF)
Request for issuance of construction permit (Apx.6 )
68
Request for issuance of construction permit (Apx.6 )
Authenticated copy of decision on EIA approval
68
Authenticated copy of decision on EIA approval
Approved design profile of fire prevention and fighting
68
Approved design profile of fire prevention and fighting
Copy of certificate on fire prevention and fighting
68
Copy of certificate on fire prevention and fighting
Report on appraisal of construction design profile
68
Report on appraisal of construction design profile
Authenticated copy of land use right certificate (Inside IZ)
68
Authenticated copy of land use right certificate (Inside IZ)
Business register certificate/ Investment certificate (of construction consulting entity)
68
Business register certificate/ Investment certificate (of construction consulting entity)
Practicing certificate of chief architect
68
Practicing certificate of chief architect
Company profile
68
Company profile
Document receipt and transfer slip (for construction permit)
69
Document receipt and transfer slip (for construction permit)
Notification on seal usage
71
Passport or Vietnamese ID card of the person submitting application file
71
Letter of Introduction
71
Letter of Introduction
Representatives
Power of attorney to applicant (x 2)
15 19
Power of attorney to applicant
Power of attorney
55
Power of attorney
Passport of the applicant
55
Passport of the applicant

How much?

Estimated cost of the procedure  VND  25,275,000

change the values with the

Cost detail

Estimate your cost

VND  30,000 per stamp
- VND 120,000
Legalization fee - assumption of 4 stamps
Stamps: 4
VND  100,000 per page to translate
- VND 3,000,000
Translation fee - assumption of 30 pages
Pages : 30
VND  2,000 per page
- VND 46,000
Authentication fee for the first and second pages - Assumption: approval for investment intent: 01 page x 15 copies; notice of Standing Party Committee: 01 page x 04 copies; passport/ID: 01 page x 04 copies.
Pages : 23
VND  2,000 per page
- VND 40,000
Authenticated fee for the first and second pages - Assumption: decision: 01 page x 10 copies; passport: 01 page x 02 copies; planning map: 01 page x 02 copies; MoU: 02 pages x 03 copies.
Pages : 20
VND  1,000 per page
- VND 12,000
Authenticated for the third page onward - Assumption: MoU: 04 pages x 03 copies
Pages : 12
VND  2,000 per page
- VND 60,000
Authentication fee for the first and second pages - Assumption: 2 pages x 15 copies.
Pages : 30
VND  1,000 per page
- VND 15,000
Authentication fee for the third page toward - Assumption: 1 page x 15 copies.
Pages : 15
VND  200,000 per document
- VND 200,000
Documents: 1
VND 300,000
Fee for announcement of enterprise registration contents
VND 350,000
Seal making fee - for reference only
VND 50,000
Fee for seal registration certificate
VND  200,000 per issue
- VND 600,000
Advertising fee: 3 consecutive issues - classified ads
Issues: 3
VND  2,000 per page
- VND 8,000
Authentication fee for the first and second pages - Assumption: 02 pages x 02 copies.
Pages : 4
VND  2,000 per page
- VND 40,000
Authentication fee for the first and second pages - Assumption: map: 01 page x 4 copies; Meeting minutes: 02 pages x 04 copies; decision: 02 pages x 04 copies.
Pages : 20
VND  2,000 per page
- VND 12,000
Authenticated fee for the first and second page - Assumption: 2 pages x 3 copies
Pages : 6
VND 100,000
Fee for land use right certificate
VND 15,000,000
Service fee for drafting EIA report - For reference only
VND 5,000,000
Fee for registering EIA report
VND  2,000 per page
- VND 20,000
Authentication fee for the first and second pages - Assumption: LURC: 02 pages x 04 copies; decision: 02 pages x 02 copies.
Pages : 10
VND  1,000 per page
- VND 2,000
Authentication fee for the third page toward - Assumption: 01 page x 02 copies.
Pages : 2
VND 300,000
Seal making fee - for reference only

How long ?

The estimated total time is calculated by adding the time spent: 1) waiting in queue, 2) at the counter and 3) between steps.
  Min. Max.
Total time (sum): 147 d 241 d
of which:
Waiting time in queue (sum): 2h. 20mn 13h.
Attention at counter: 19h. 20mn 40h. 15mn
Waiting time until next step (sum): 147 d 240 d

Legal justification?

The regulations which justify the procedure and its content
 Circular No.03/2008/TT-BTP dated 25 Aug 2008_EN Circular No.03/2008/TT-BTP of the Ministry of Justice dated August 3, 2008 guiding the implementation of a number of article of the Governments Decree No. 79/2007/ND-CP dated May 18, 2007, on the issue of copies master registers, authentication of copies from originals, authentication of signatures
  articles 1, 2, 3, 5, 6, 7
 Law on Tax Management No. 78/2006/QH11 dated 29 Nov 2006_EN Law No. 78/2006/QH11 dated 29 Nov 2006 of National Assembly on Tax Management
  articles 21, 22, 23, 24, 25, 26, 28, 29
Amendment Law No. 38/2009/QH12 dated 19 June  2009 regarding capital construction investment. Amendment Law No. 38/2009/QH12 dated 19 June 2009 regarding capital construction investment.
  articles 1.1, 1.7
Circular No. 01/2012/TT-BNG dated 20 Mar 2012_EN Circular No. 01/2012/TT-BNG of the Ministry of Foreign Affairs dated March 20, 2012 guiding a number of provisions of the Government’s Decree No. 111/2011/ND-CP of December 5, 2011, on consular certification and legalization
  articles 1, 6, 9, 10, 11, 13
Circular No. 03/2008/TT-BTP Circular No. 03/2008/TT-BTP of the Ministry of Justice dated August 3, 2008 guiding the implementation of a number of article of the Governments Decree No. 79/2007/ND-CP dated May 18, 2007, on the issue of copies master registers, authentication of copies from originals, authentication of signatures
  articles 1, 2, 3
Circular No. 07/2010/TT-BCA dated 05 Feb 2010_VI Circular No. 07/2010/TT-BCA of the Ministry of Public Security dated February 5, 2010 on stipulating in detail a number of articles of Decree No. 58/2001/NĐ-CP dated August 24, 2001 on management and use of seals and supplementing a number article of Decree No. 31/2009/NĐ-CP dated April 1, 2009
  Article 4
Circular No. 09/2007/TT-BTNMT dated  02 Aug 2007_VI Circular No. 09/2007/TT-BTNMT dated 02 Aug 2007_VI
  articles II.3.(3.3), II.3.2
Circular No.10/2012/TT-BXD dated 20 Dec 2012_EN Circular No. 10/2012/TT-BXD of the Ministry of Construction dated December 20, 2012 guiding in detail some contents of Decree No. 64/2012/ND-CP dated September 04, 2012 of the government concerning issuance of Construction permit
  articles 5, 10.2, 11
Decision No. 10/2013/QD-UBND dated 28 May 2013_VI Circular No. 10/2013/TT-BXD of the Ministry of Construction dated July 25, 2013 on construction quality management
  Article 14.3
Circular No. 128/2008/TT-BTC dated 24 Dec 2008_EN Circular No. 128/2008/TT-BTC dated 24 Dec 2008_EN
  Article B.I.1; B.II.1
Circular No. 13/2013/TT-BXD dated 15 August 2013_EN Circular No. 13/2013/TT-BXD of the Ministry of Construction dated August 15, 2013, prescribing verification, appraisal and approval for works construction design
  articles 3.1.b, 20
Circular No. 14/2009/TT-BTNMT dated 01 Oct 2009_EN Circular No. 14/2009/TT-BTNMT dated 01 Oct 2009_EN
  Article 28.1
Circular No. 156/2013/TT-BTNMT dated 06 Nov 2013_VI Circular No. 156/2013/TT-BTC dated 06 Nov 2013_EN
  articles 28, Appendix
Circular No. 16/2011/TT-BTNMT dated 20 May 2011_VI Circular No. 16/2011/TT-BTNMT dated 20 May 2011_VI
  Article 3
Circular No. 16/2015/TT-BKHDT of the Ministry of Planning and Investment dated November 18, 2015 issuing standard forms for conducting investment procedures and report on investment in Vietnam Circular No. 16/2015/TT-BKHDT of the Ministry of Planning and Investment dated November 18, 2015 issuing standard forms for conducting investment procedures and report on investment in Vietnam
  articles I.1, I.3
Circular No. 17/2009/TT-BTNMT dated 21 Oct 2009_VI Circular No. 17/2009/TT-BTNMT dated 21 Oct 2009_VI
  Article Apdx. 2
Circular No. 17/2013/TT-BXD dated 30 Oct 2013 Circular No. 17/2013/TT-BXD dated 30 Oct 2013 of the Ministry of Construction on cost for construction survey
  articles 7.4, 8.3
Circular No. 20/2015/TT-BKHDT of the Ministry of Planning and Investment dated December 1, 2015 on business registration Circular No. 20/2015/TT-BKHDT of the Ministry of Planning and Investment dated December 1, 2015 on business registration
  articles I.10, I.2, I.3, I.4, I.6, I.7, I.8, II.25, II.8
Circular No. 215/2016/TT-BTC dated Nov 10, 2016 of the Ministry of Finance on the fee tariff, collection, payment, management and use of fees for enterprises information provision and enterprises registration Circular No. 215/2016/TT-BTC dated Nov 10, 2016 of the Ministry of Finance on the fee tariff, collection, payment, management and use of fees for enterprises information provision and enterprises registration
  Article 4
Circular No. 26/2011/TT-BTNMT dated 18 July  2011_EN Circular No. 26/2011/TT-BTNMT of the Ministry of Natural Resources and Environment detailing a number of articles of the Government’s Decree No. 29/2011/ND-CP dated April 8, 2011 on strategic environmental assessment, environmental impact assessment and environmental protection commitment
  articles 10, 12, 13, 14, 15, 15.2
Circular No. 36/2004/TT-BTC dated 26 April 2004_VI Circular No. 36/2004/TT-BTC of the Ministry of Finance dated April 26, 2004 stipulating the collection, payment and management on using legalization fees, consular certification
  Article I.3
Circular No. 80/2012/TT-BTC dated 22 May 2012_EN Circular No. 80/2012/TT-BTC of the Minister of Finance dated May 22, 2012 guiding the law on tax administration with regard to tax registration
  articles 3, 4, 5, 6, 7, 8
Circular No. 94/2011/TT-BTC dated 29 June 2011_EN Circular No. 94/2011/TT-BTC dated 29 June 2011_EN
  articles 1, 3, 8.1.1
Circular No. 98/2011/TT-BTC  dated 05 July 2011_VI Circular No. 98/2011/TT-BTC of the Ministry of Finance dated July 5, 2011 amending and supplementing Circular No. 36/2004/TT-BTC dated April 26, 2004 of the Ministry of Finance stipulating the collection, payment and management on using legalization fees, consular certification
  Article 1
Circular No.193/2010/TT-BTC dated 02/12/ 2010 of Ministry of Finance regulating some fees Circular No.193/2010/TT-BTC of the Ministry of Finance dated December 2, 2010, providing for the collection, remittance, management and use of the fee for appraisal of security conditions
  Article 3
Circular No.21/2012/TT-BCA dated 13 Apr 2012_VI Circular No.21/2012/TT-BCA of the Ministry of Public Security dated April 13, 2012 providing for seals of the State's agencies and titles
  Article 10
Decision No. 1088/2006/QD-BKH dated 19 Oct 2006_EN Decision No. 1088/2006/QD-BKH of the Ministry of Planning and Investment dated October 19, 2006, issuing standard forms for conducting investment procedures in Vietnam
  Article Apdx.II-3
Decision No. 13/2006/QĐ-BTNMT dated 08 Sep 2006_VI Decision No. 13/2006/QD-BTNMT of the Ministry of Natural Resources and Environment promulgating the Regulation on organization and operation of the Council for appraisal of strategic environment assessment reports and the Council for appraisal of environmental impact assessment reports
  articles 6, 13, 14, 15, 17
Decision No. 22/2012/QD-UBND dated 20 July 2012_VI Decision No. 22/2012/QD-UBND dated 20 July 2012_VI
  articles 2, 3
Decision No. 2910/QD-CT dated Decision No. 2910/QD-CT of VInh Phuc's People Committe on approval of price for cartrography map and registration for land use right certificate
  Article Appendix
Decision No. 41/2012/QD-UBND dated 29 Oct 2012_EN Decision No. 41/2012/QD-UBND Regulation on “one stop service” administrative procedure settlement on direct investment projects at Vinh Phuc Investment Promotion Agency
  articles 7, 8, 9, 12, 13, 14, 15, 16, 17
Decision No. 49/2009/QD-UBND Decision No. 49/2009/QD-UBND dated 28 Aug 2009 on the rates of fees for authenticated version, authentication in Vinh Phuc province
  Article 1
Decree No. 04/2012/ND-CP Decree No. 04/2012/ND-CP of the Government dated January 20, 2012 amending and supplementing article 5 of the Government’s Decree No. 79/2007/ND-CP dated May 18, 2007 on the issue of copies from master registers, authentication copies from originals, authentication of signatures
  Article 1
Decree No. 108/2006/ND-CP Decree No. 108/2006/ND-CP of the Government dated 22 september 22, 2006 providing guidelines for implementation of a number of articles of Law on Investment
  articles 4, 41
Decree No. 111/2011/ND-CP dated 5 Dec 2011_EN Decree No. 111/2011/ND-CP of the Government of December 5, 2011, on consular certification and legalization
  articles 14, 15
Decree No. 118/2015/ND-CP of the Government dated November 12, 2015 providing guidelines for implementation of a number of articles of Law on Investment Decree No. 118/2015/ND-CP of the Government dated November 12, 2015 providing guidelines for implementation of a number of articles of Law on Investment
  articles 23, 24, 28, 29
Decree No. 12/2002/ND-CP dated 22 Jan 2002_EN Decree No. 12/2002/ND-CP dated 22 Jan 2002 of Goverment on geodesic and cartographic activities
  Article 5
Decree No. 12/2009/ND-CP dated 12 Feb 2009_EN Decree No. 12/2009/ND-CP dated 12 February 2009 on management of investment projects on the construction of works
  articles 2.2, 2.3.c, 7
Decree No. 121/2010/ND-CP dated 30 Dec 2010_EN Decree No. 121/2010/ND-CP dated 30 Dec 2010_EN
  articles 2.3, 2.4, 2.5, 2.6, 2.11
Decree No. 142/2005/ND-CP dated 14 Nov 2005_EN Decree No. 142/2005/ND-CP dated 14 Nov 2005_EN
  articles 2.1.b, 4, 5, 6, 7, 8, 9, 18, 21
Decree No. 15/2013/NĐ-CP dated 06 Feb 2013_EN Decree No. 15/2013/ND-CP of the Government dated February 6, 2013, on quality management of construction works
  Article 20.1
Decree No. 181/2004/ND-CP dated 29 Oct 2004_EN Decree No. 181/2004/ND-CP dated 29 Oct 2004_EN
  articles 30.1, 36, 38, 39, 125.2, 125.3.c, 125.4, 126.5, 126
Decree No. 29/2011/ND-CP dated  18 April 2011_EN Decree No. 29/2011/ND-CP of the Government dated April 8, 2011 on strategic environmental assessment, environmental impact assessment and environmental protection commitment
  articles 12, 13, 14, 15, 16, 17.2, 17, 18, 19, 19.2, 19.3, 19.4, 20.2, 20.1, 20.3, 40, Appendixes, Appendixes II
Decree No. 31/2009/ND-CP dated 01 Apr 2009_EN Decree No. 31/2009/ND-CP of the Government dated April 1, 2009 on amending and supplementing a number of articles of the Government’s Decree No 58 /2001/ND- CP dated August 24, 2001 on management and use of seals
  Article 1.5
Decree No. 43/2014/ND-CP dated 15 May 2014_VI Decree No. 43/2014/ND-CP of the Government dated May 5, 2014 detailing the implementation of a number of articles of the Law on Land
  Article 70.2.b
Decree No. 58/2001/ND-CP dated 24 August 2001_EN Decree No. 58/2001/ND-CP of the Government dated August 24, 2001 on management and use of seals
  Article 10.2
Decree No. 60/2003/ND-CP dated 06 June 2003_EN Decree No. 60/2003/ND-CP dated 06 June 2003_EN
  articles 2.6, 47
Decree No. 64/2012/ND-CP dated 04 Sep 2012_EN Decree No. 64/2012/ND-CP of the Government dated September 04, 2012 on construction permit
  articles 5, 5.3, 8.3, 8, 9, 9.6, 21.6
Decree No. 69/2009/ND-CP dated 13 Aug 2009_EN Decree No. 69/2009/ND-CP dated 13 Aug 2009_EN
  articles 11, 12, 13, 28.2 and 36, 29.2, 29.3, 31.1, 36.2
Decree No. 78/2015/ND-CP of the Government dated September 19, 2015 on enterprise registration Decree No. 78/2015/ND-CP of the Government dated September 19, 2015 on enterprise registration
  articles 22, 23, 34, 55
Decree No. 79/2007/ND-CP Decree No. 79/2007/ND-CP of the Government dated May 18, 2007 on the issue of copies from master registers, authentication copies from originals, authentication of signatures
  articles 5.1.b, 5, 5.1.a, 7, 13, 14, 15, 18
Decree No. 79/2014/ND-CP of July 31, 2014 on detailing the implementation of a number of articles of the Law on fire prevention and fighting Decree No. 79/2014/ND-CP of July 31, 2014 on detailing the implementation of a number of articles of the Law on fire prevention and fighting
  articles 15, 17.5, Apdx IV
Decree No. 83/2013/ND-CP dated 22 July 2013 Decree No. 83/2013/ND-CP dated 22 July 2013_EN
  articles 24.3, 26
Decree No. 88/2009/ND-CP dated 19 Oct 2009_EN Decree No. 88/2009/ND-CP dated 19 Oct 2009_EN
  articles 3.3, 19.1, 19.1.d, 20, 21.1.g, 21.1, 22.1, 22.1.e
Joint Circular No. 04/2007/TTLT/BTNMT-BTC dated 27 Feb 2007_VI Joint Circular No. 04/2007/TTLT/BTNMT-BTC guiding the estimation of funds for topography and land administration
  articles II.B.1, II.B.2
Joint Circular No. 07/2002/TTLT-BCA-BTCCBCP dated 06 May 2002_EN Joint Circular No. 07/2002/TTLT-BCA-BTCCBCP the ministry of public security - government commission on organization and personnel dated May 06, 2002 on guiding implementation of a number of provisions in the Government’s Decree no. 58/2001/ND-CP, of august 24, 2001 on management and use of seals
  articles II.A.4.2, II.A.6
Joint Circular No. 92/2008/TTLT-BTC-BTP dated 17 Oct 2008 Joint Circular No. 92/2008/TTLT-BTC-BTP of the Ministry of Finance and the Ministry of Justice dated October 17, 2008 on guiding the rates and the collection, remittance, management and use of fees for the issue of copies and authentication fees
  Sections II.1, II.1.b ,  articles II.1, II.1.b
Law on Environment Protection No. 52/2005/QH11 dated 29 Nov 2005_EN Law No. 52/2005/QH11 of the National Assembly on Environmental Protection
  articles 18, 19, 20, 21, 22, 22.3
Law on Enterprise 2005 Law No. 60/2005/QH11dated 29/11/2005 of National Assembly on Enterprises
  Article 28
Law No. 67/2014/QH13 dated November 26 of the National Assembly on Investment Law No. 67/2014/QH13 dated November 26 of the National Assembly on Investment
  articles 22, 33.1, 36.1.a, 37.2, 38
Law No. 68/2014/QH13 dated 26/11/2014 of the National Assembly on Enterprises Law No. 68/2014/QH13 dated 26/11/2014 of the National Assembly on Enterprises
  articles 21, 22, 23, 24, 25, 26, 27, 33, 44.1, 44.2
Law on Construction No. 16/2003/QH11 dated 26 Nov 2003_EN Law No.16/2003/QH11 of the National Assembly on Construction
  articles 38, 39, 41, 44.2.a, 56, 57.2.dd, 59, 62, 63, 63.1.b, 64
Law on Land No. 13/2003/QH11 dated 26 November 2003_EN Law on Land No. 13/2003/QH11 dated 26 Nov 2003_EN
  articles 4.2, 6.2.c, 9.7, 17.4, 40, 46, 48, 49, 51.3, 52, 122.3, 122, 122.2, 122.1
Law on State Budget No. 01/2002/QH11 dated 16 Dec 2002_EN Law on State Budget No. 01/2002/QH11 dated 16 Dec 2002_EN
  Article 54.3
Amendment Ordinance No. 06/2013/UBTVQH13 dated 18 Mar 2013_EN Ordinance amending and supplementing a number of articles of the Ordinance on foreign exchange control No. 06/2013/UBTVQH13 It amends and supplements to the Ordinance on Foreign Exchange No. 28/2005/PL-UBTVQH11.
  Article 1.4
Ordinance on Foreign Exchange No. 28/2005/PL-UBTVQH11 dated 13 Dec 2005_EN Ordinance on Foreign Exchange No. 28/2005/PL-UBTVQH11 dated 13 Dec 2005 (as amended in 2013) The article 11 is amended by clause 4, article 1 of the Ordinance No. 06/2013/UBTVQH13 amending the Ordinance on Foreign Exchange 2005 which takes effect as from 01 Jan 2014.
  Article 11
Resolution No. 13/2007/NQ-HDND dated 04 July 2007_VI Resolution No. 13/2007/NQ-HDND dated 04 July 2007 of People's Coucil on levels and methods of collection; management and usage of fees
  Article Appendix
Powered by eRegulations (c), a content management system developed by UNCTAD's Investment and Enterprise Division, Business Facilitation Program and licensed under Creative Commons License
